China Resources and Datang 610MW Wind Power Project Unit Start Bidding!
North Star Wind Power Network News: On February 21st, a procurement announcement was issued for wind turbines and ancillary equipment for the China Resources Weichang Chaoyang 200MW project, China Resources Weichang West Longtou 200MW wind power project, China Resources Qinghe 300MW wind power project 150MW market-oriented project, and Datang New Energy Lulong Lunan 60MW wind power project, with a total scale of 610MW.

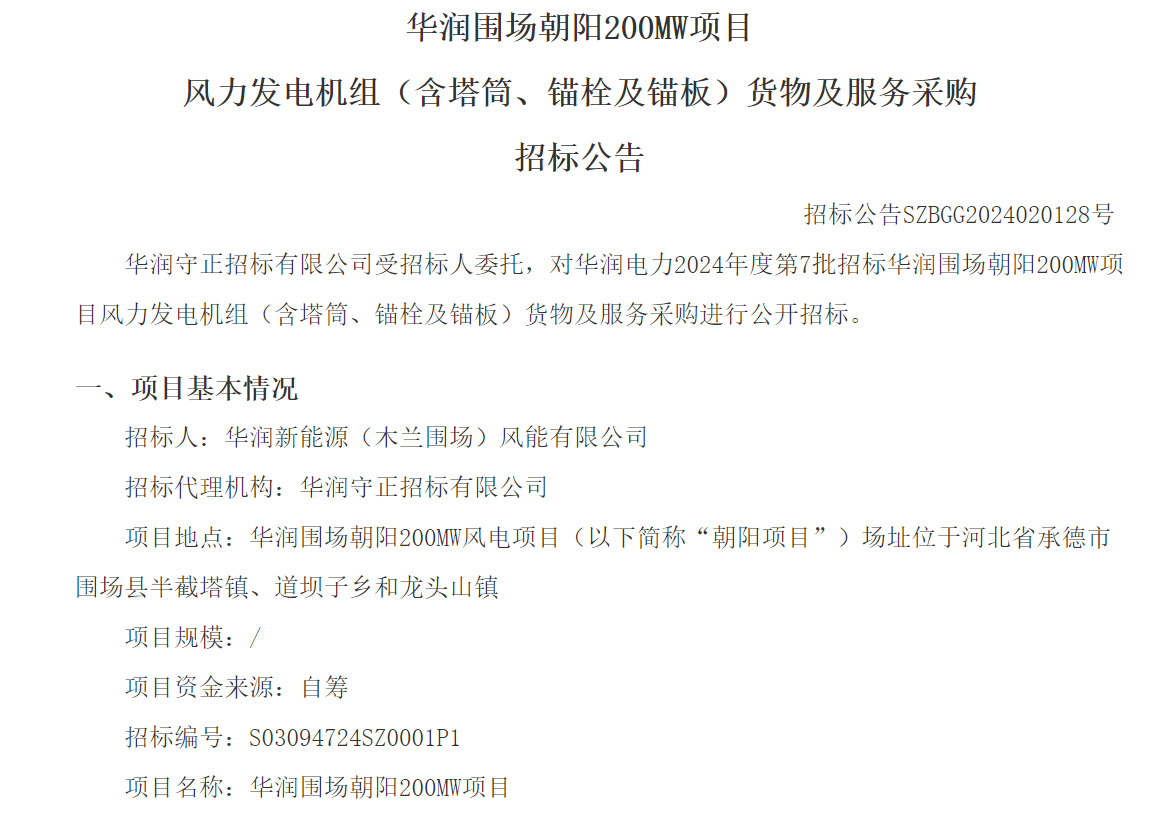

According to the bidding announcement, the China Resources Weichang Chaoyang 200MW project is located in Banjieta Town, Daobazi Township, and Longtoushan Town, Weichang County, Chengde City, Hebei Province. The installed capacity must be 200MW (not subject to capacity limitations), and the project consists of 32 wind turbines with a single capacity of 6.25MW. The total number of mixed exhaust models in the project cannot exceed 2. Delivery date/schedule: (1) Anchor bolts and anchor plate assemblies: to be delivered and completed on June 15, 2024; (2) Tower and wind turbines: The first batch of 8 sets of tower and wind turbines will arrive on August 15, 2024 (including all necessary lifting tools); The second batch of 8 sets will arrive on September 15, 2024; The third batch of 8 sets will arrive on October 15, 2024; The fourth batch of 8 sets arrived on November 15, 2024.

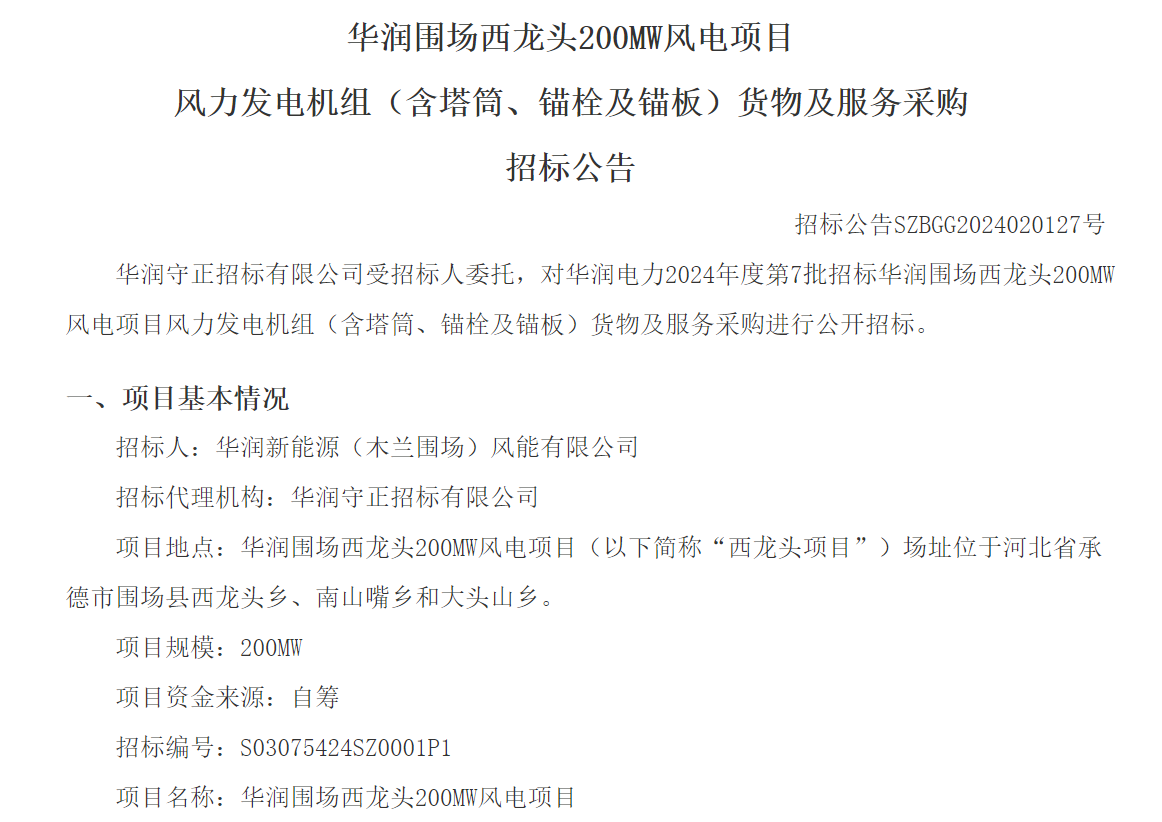

The CR Weichang West Longtou 200MW wind power project is located in Xilongtou Township, Nanshanzui Township, and Datoushan Township, Weichang County, Chengde City, Hebei Province. The installed capacity must be 200MW (capacity limitation is not accepted), and the project consists of 32 wind turbines with a single capacity of 6.25MW. The total number of mixed exhaust models in the project cannot exceed 2. Delivery date/schedule: (1) Anchor bolts and anchor plate assemblies: to be delivered and completed on June 15, 2024; (2) Tower and wind turbines: The first batch of 8 sets of tower and wind turbines will arrive on August 15, 2024 (including all necessary lifting tools); The second batch of 8 sets will arrive on September 15, 2024; The third batch of 8 sets will arrive on October 15, 2024; The fourth batch of 8 sets arrived on November 15, 2024.
The Huarun Qinghe 300MW wind farm project and the 150MW market-oriented project are located in towns such as Youfang Town, Xielu Town, Baying Town, and Wangguanzhuang Town in Qinghe County. The single machine capacity is 5MW, with 30 machine positions, and a total capacity of 150MW. Delivery date/schedule: Complete the supply of all anchor bolt components or other basic embedded parts (if any) before July 10, 2024; Provide the first batch of no less than 10 sets of wind turbines and towers by August 31, 2024; Provide the second batch of remaining wind turbines and towers by September 30, 2024; Provide the remaining third batch of wind turbines and towers by November 30, 2024.

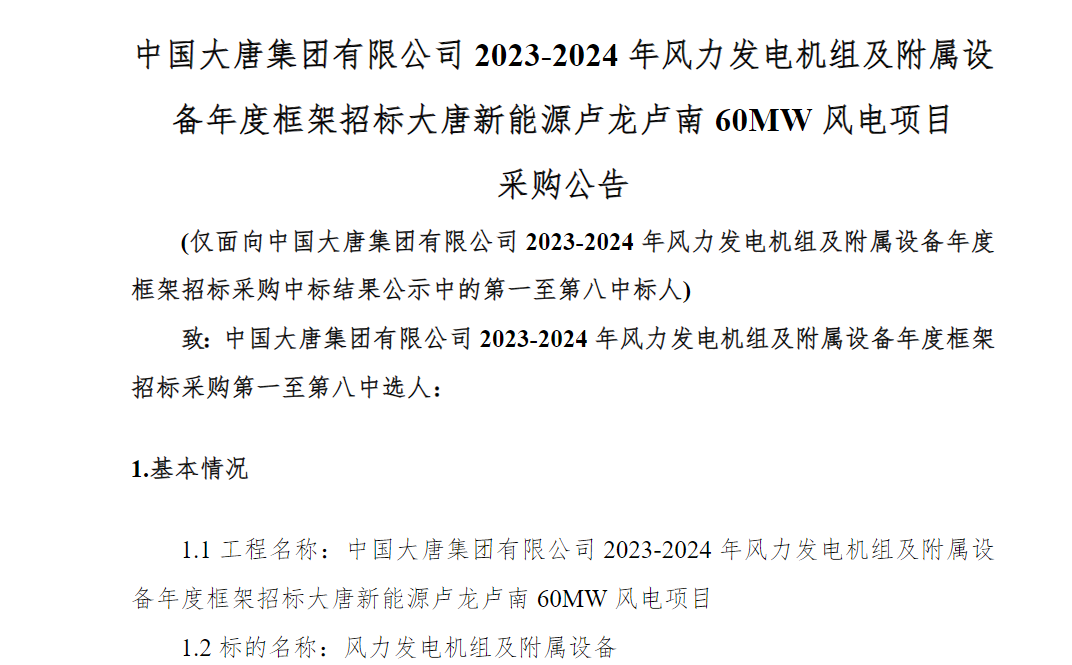

The total capacity of Datang New Energy Lulong Lunan 60MW wind power project is 60MW, and no fluctuation is allowed. 5.5MW ≤ single unit capacity ≤ 6.25MW, and 1 unit is allowed to reduce capacity. The total number of units in this project is ≤ 10; Impeller diameter ≥ 200 meters, 115 meters ≤ hub height ≤ 140 meters; Accept mixed arrangement and limit steel towers. Delivery date: May October 2024.
*Some documents are sourced from the internet. If there is any infringement, please contact the website to delete them
- ● Jinhai Corporation and CRRC Qishuyan Institute had a discussion and exchange[2024-11-29]
- ● Talking about 'new' voices and attending the 2024 New College Student Symposium at Xincheng Jinhai Co., Ltd[2024-11-29]
- ● Wind power hybrid tower industry factory production capacity evaluation continues - Zhonghan Energy Baotou Production Base[2024-11-16]
- ● Research on Defects and Reinforcement Repair Technology of Wind Power Concrete Tower Structure[2024-11-16]
- ● 2024 Wind Power Hybrid Tower Industry Factory Capability Evaluation Results Released - Zhonghan Energy (Shanghai) Co., Ltd. - Baotou Production Base[2024-11-16]
- ● The 2024 Jinhai Wind Power Truss Tower Promotion Conference and Technical Seminar were successfully held[2024-11-11]
- ● Segmented straight tower prestressed concrete tower | Inner Mongolia Jinhai New Energy Technology Co., Ltd[2024-10-30]
- ● Peng Ke, Chairman of Jinhai Group, led a team to visit the First Aviation Administration for exchange[2024-10-26]
- ● Inner Mongolia Jinhai New Energy Technology Co., Ltd. - Gulang Production Base conducted an on-site evaluation of the production capacity of wind power hybrid tower industry factories for 2024, and the results were publicly announced[2024-10-26]
- ● Jinhai Co., Ltd. was invited to attend the Fourth President's Meeting and the Second First Member's Meeting of the Wind Power Engineering Branch of the China Electric Power Construction Enterprise Association[2024-10-18]
